China is the name that  comes to mind  when talking about  megaconstructions . The country has faced some of the most complex works of recent years and boasts  pharaonic projects  such as the largest dam in the world and the most complicated tunnel. In this matter,  Europe  is not far behind, with two notable projects aimed at becoming the longest tunnels in the world in different fields: the largest submerged tunnel, covering  120 kilometers , and the world’s longest rail tunnel, the Brennero Base Tunnel.

A  2006 project  finally yielding results.

Brennero’s Base Tunnel is a monumental undertaking that has experienced numerous delays and changes in its estimated timeline and completion dates. Official construction began in 2007, yet the excavation did not commence until  2015 . This tunnel is part of the  Scandinavia-Mediterranean European Corridor  (or Scan-Med) and will connect the Munich-Verona axis. Its primary goal is to enhance communication among countries by overcoming a considerable natural barrier: the  Alps .

This development is pivotal for improving the commercial and passenger railway networks in  Europe , allowing trains to reduce reliance on airplanes as part of a larger decarbonization strategy. This will not only facilitate faster connections between  Germany  and  Italy  but also transfer much of the Alpine freight traffic from roads to rail. The resulting benefits include reduced traffic jams, lower CO₂ emissions, and a significant boost in logistics efficiency between  northern  and  southern Europe .

 <img alt="Italy's Colossal Build: The Messina Bridge" width="375" height="142" src="https://i.blogs.es/defd5c/puente-de-messina/375_142.jpeg"/>

Colossal in scope, the Brennero Base Tunnel will span a total length of  64 kilometers . Once operational, it will officially be the longest railway tunnel globally. The main section connecting  Fortezza  in Italy and  Innsbruck  in Austria will measure about  55 kilometers , comprising two parallel tunnels with a single route each.

These will be interconnected every  333 meters  through service tunnels, allowing for safe evacuation in emergencies. A unique feature of this tunnel is that it will be designed as a  “flat” tunnel , remaining at approximately  794 meters  above sea level throughout the journey. This design minimizes energy consumption, as current trains navigating through the Alps often require several locomotives due to steep inclines.

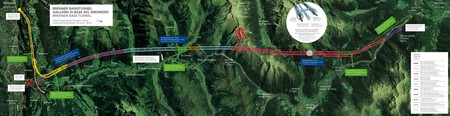

Long railway tunnel

Beyond transportation, the plan also allows for the passage of freight trains weighing up to  3,000 tons , alongside passenger trains capable of operating at high speeds, up to  250 km/h . Presently, the average speed is around  50 km/h  due to geographical constraints. Furthermore, another tunnel with a  five-meter diameter  will be situated  a dozen meters  below the main tunnels, serving as an exploratory channel for geological research as well as enabling groundwater drainage.

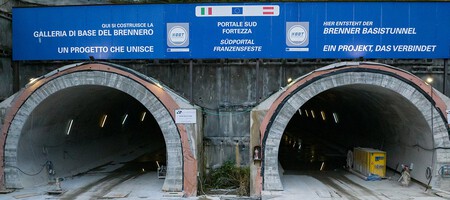

Exploratory Tunnel Structure
Exploratory Tunnel Structure

Current State and Next Steps. Initially, the Brennero project was expected to be completed by  2025 , but shifting circumstances have altered that timeline. The Alps pose significant challenges due to  subterranean failures  and water bodies, impacting excavation techniques and approaches to tunneling under rivers and the Isarco. Administrative delays, especially between  Austria  and  Italy , have further complicated progress. The onset of the  COVID-19 pandemic  also stalled work.

Consequently, the initial budget of  €6 billion  has ballooned to about  €8.4 billion . However, a green breakthrough occurred recently when advanced excavators like  Flavia  significantly expedited tunneling. On  September 18 , Italian and Austrian excavation teams achieved a historical connection between the two countries.

While this milestone is commendable, substantial work remains in covering the tunnels, laying down rail infrastructure, and incorporating technical systems for ventilation and signaling.

 <img alt="Modern Tunnel Construction Equipment" width="375" height="142" src="https://i.blogs.es/763bc1/xtk---plantilla-portada-dividida-3/375_142.jpeg"/>

Piercing the Alps, the target completion date is set for  2032 , when the tunnel is expected to be operational for transporting goods and passengers. Notably, Brennero is not the only monumental project underway in the  Alpine region ; several others, including the  Mont Cenis  tunnel, which will measure  57.5 kilometers  and connect  Lyon  with  Turin , and the  San Giardardo base tunnel  at  57.1 kilometers , linking the Swiss towns of  Erstfeld  and  Bodio  are also in progress.

Moreover, there are additional tunnels, such as  Koralm  (32 km),  Semmering  (27 km),  Ceneri  (14.5 km), and  Lötschberg  (34.6 km). The common objective across these projects is to  facilitate transalpine transport , effectively reducing CO₂ emissions while expediting the movement of both passengers and freight. As these ambitious undertakings progress, the focus remains on meeting construction timelines and delivering on their promises.
